Methodology

Detailed
description
of the value

An overview of proven methodologies for maximizing project value through phased execution, early optimization, cost management, EPC strategy, and industry best practices across the project lifecycle.

01 · Phased approach

Project execution phases

The most common approach to capital projects is the phased approach — proven to be profitable and to best meet the requirements of the project and its shareholders.

Main advantages

  • Accepted in the industry as the most effective
  • Clear separation of types and results of work at each phase
  • Enables step-by-step, meaningful investment in the project

The essence of the approach

  • The implementation process is divided into phases
  • At the end of each phase, a decision is made on the transition to the next one — the Final Investment Decision is made when moving from phase 3 to phase 4
  • Three possible decisions at each gate: move forward, return and refine, or stop the project

02 · Scope per phase

Scope of works at each phase

A brief description of the essence of work and the results delivered at each phase.

Identify

Assess project feasibility and alignment with company strategy. Result: project framework and business goals.

Select

Compare project execution options. Result: case study report.

Define

Elaborate the selected option. Result: final project framework, cost and schedule.

Execute

Detailed design, procurement, construction, and start-up (EPC). Result: working production at final price and deadline.

Operate

Operate the asset with finished products and profit. Result: operational activities.

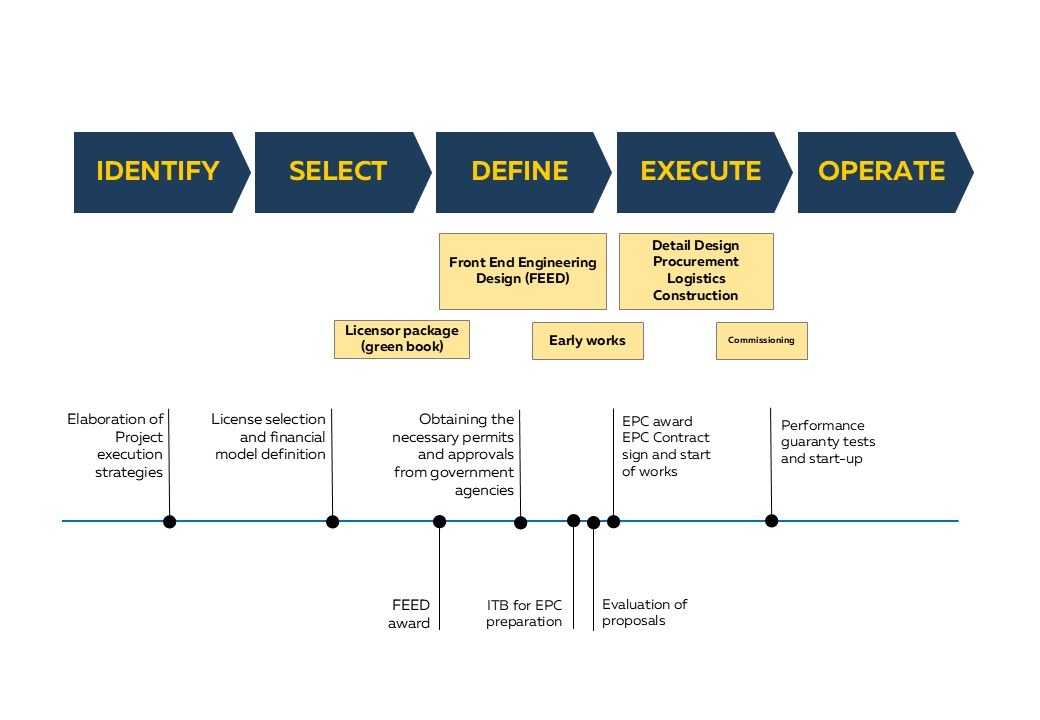

Project milestones across Identify, Select, Define, Execute and Operate phases

03 · Value & cost

Value formation and cost optimization

The positive effect on project cost is greatest at the initial stages, when it is still possible to change project indicators and make the right technical and commercial decisions. The ability to influence performance drops significantly after the final investment decision.

It is critically important to involve a professional team at the preliminary study stage to ensure the value of the project is formed. The cost of qualitative early study is many times less than the cost of implementation — and leads to many times greater results.

04 · Accuracy by phase

Cost and schedule accuracy depending on the phase

Engineering, procurement, construction, cost, and schedule maturity grow as the project advances (level of development 0–2% → 50–95%, cost estimate classes 5 → 1 per AACE methodology).

DisciplineIdentifySelectDefineExecute
EngineeringConceptual design · Pre-FEEDCase Study · BEDP, FEED · ITB packageDetail DesignAs-built documentation
ProcurementProcurement strategy · AnalogsBenchmarking · Requests for quotationBidding · Contracting · ExecutionOperation procurement
ConstructionConstruction strategyStrategy analysis · Requests for quotationBidding · Contracting · Execution
Cost classClass 5 (−50% / +100%)Class 4 (−30% / +50%)Class 3 (−20% / +30%)Class 2–1 (−15/+30% · −10/+15%)
ScheduleLevel 1Level 2Level 3Level 4

05 · Best practices

Value Improvement Practices (VIP)

The main Value Improvement Practices should be applied in the preliminary phases of the project, where they deliver the largest impact on value and cost.

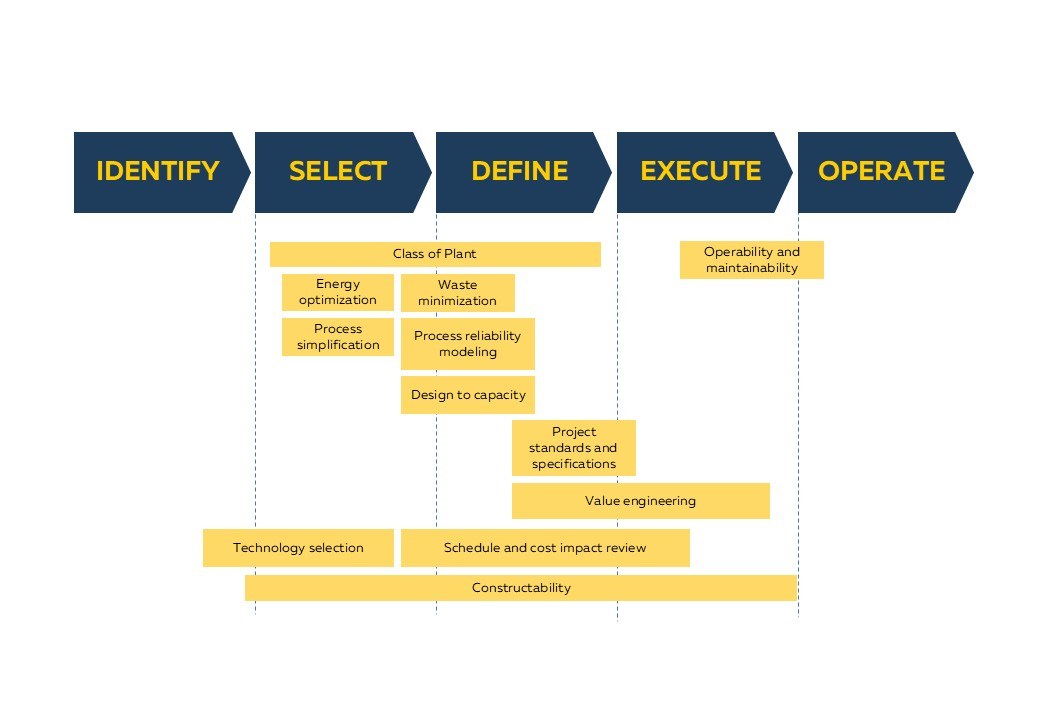

Value Improvement Practices mapped across the project phases

06 · Contracting

EPC contracting strategy

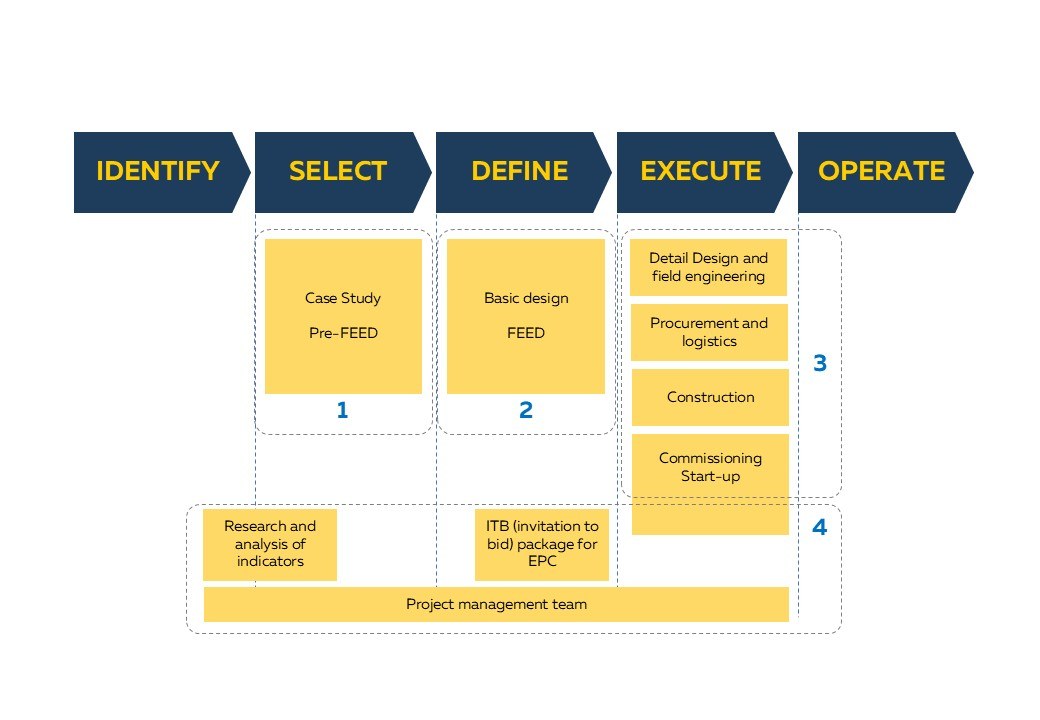

EPC contracting strategy across the project phases
1

Preliminary design contracts

Preliminary study and formation of the main indicators of the project.

2

Basic design & ITB technical package

Elaboration of the main technical solutions for determining the budget.

3

EPC contract

Determined by a competition based on the ITB. The main cost of the project is formed.

4

Owner's contracts

Concluded by the Owner with third parties for independent performance of works.

07 · Team & cost structure

Cost, competencies & team size

On the example of a project worth 1 billion USD — how cost and team size grow across the four phases. *of procurement cost · **of construction cost.

IndicatorIdentifySelectDefineExecute
Total project execution cost0.1%0.5%1.4%98%
Engineering cost0.1%0.5%1.4%8%
Procurement & logistics cost10%*30%
Construction cost5%**50%
Owner's project team (people)163873177
Contractor's project team (people)20902007000

08 · Organization

Project team organization chart

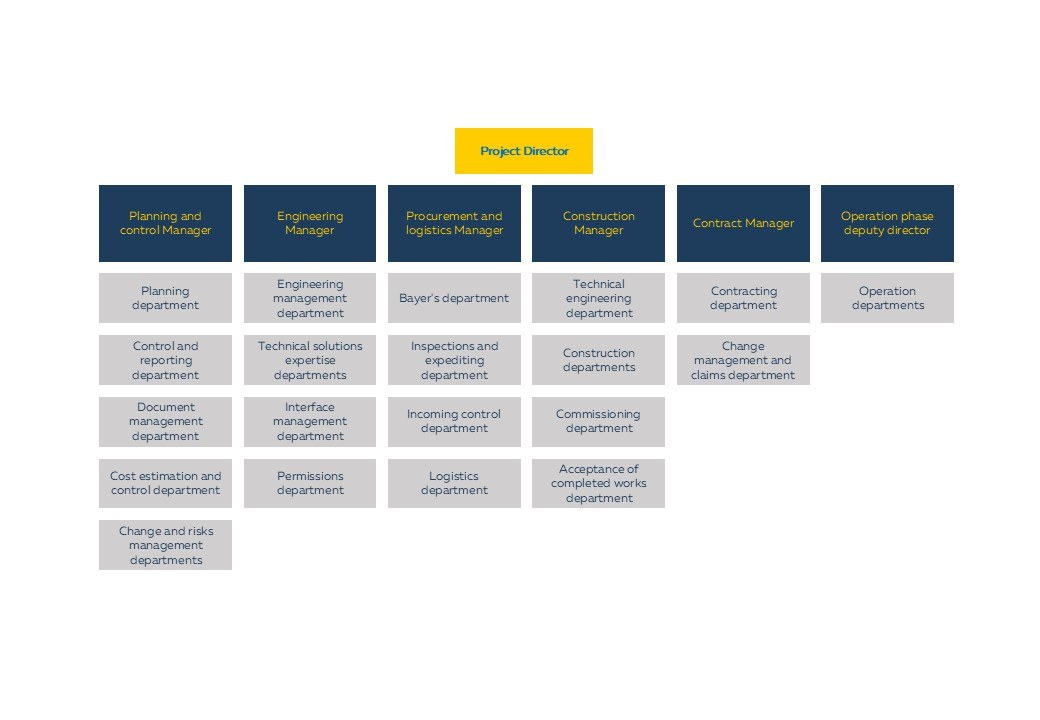

The structure of the main divisions of the project team at phase 4 (Execute). The number of specialists and departments changes depending on the execution phase.

Project team organization chart at the execution phase
